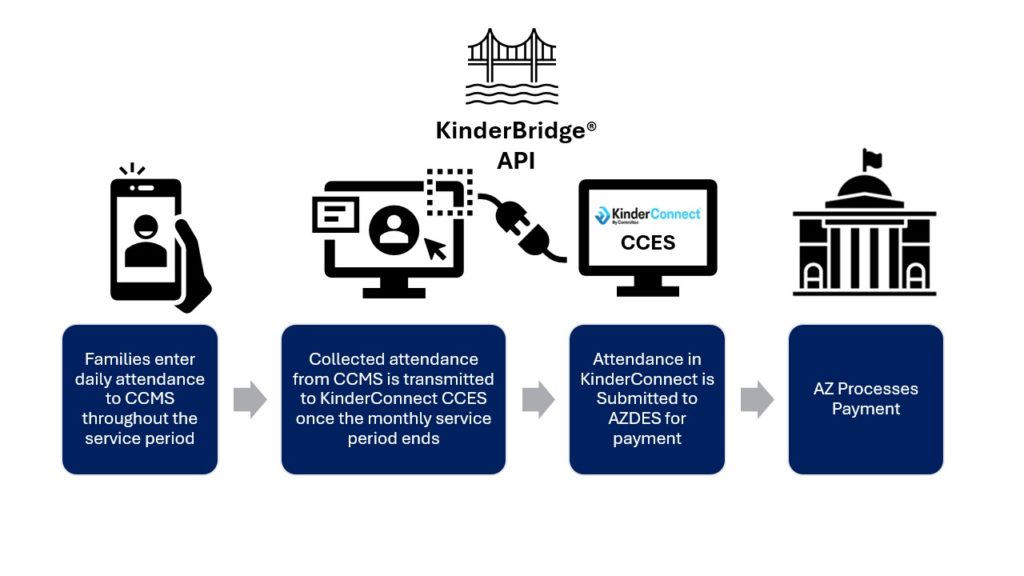

Kindersystems® has developed KinderBridge®, an API that facilitates the transfer of attendance data to KinderConnect® by CCMS vendors. The integration process is designed to be completed within 60 days, but it's subject to the CCMS's availability to start allocating resources.

Ready to get started?

Here's a breakdown of the process:

  1. Sign an NDA & Schedule an Introductory Call:

a. Kindly provide us with the name, email, and position of the person to whom we should send the NDA. You can send this information to partners@controltec.com.
b. Schedule a 15-minute call by clicking here to discuss the process and the next steps.

  1. Deliver API Specification & Provide Sandbox Access:

KinderSystems will provide the CCMS with the API specification and documentation. The CCMS will receive OIDC credentials to connect with the KinderSystems sandbox environment.

  1. Validate Test Cases in Sandbox:

KinderSystems will provide ten user cases to test the integration. Once the CCMS submits the test case data, it will audit the received data. If any inconsistencies are identified during this process, KinderSystems may request additional data transmission as necessary. This step must be fully completed to proceed to the next step in the certification process.

  1. Validate Cases with PROD data in UAT:

Once the necessary test cases are completed in the Sandbox environment, KinderSystems will provide CCMS with the required credentials and endpoints to access a lower environment in Arizona, known as Arizona UAT. This environment is an exact replica of the production (PROD) environment. In this lower environment, the same scenarios tested in the Sandbox will be run, but with real data.

KinderSystems will request attendance data for the previous months to perform this verification. CCMS needs to select at least three providers that are already working with them and are registered as subsidy providers. Attendance records from these providers should then be transferred into Arizona UAT, covering at least three months of attendance data.

There are two main goals for this test:

  1. Technical integration work—i.e., making accurate calls to the API based on the spec and use cases provided.
  2. Operational tests - These are not necessarily predicated on a correct integration since this will be mostly assumed to be working as expected. Instead, they are intended to identify any workflow issues that may be introduced by system users. Examples:
    a. The users are not properly logging absences
    b. The users are creating incomplete time pairs (only an in, without an out, or the reverse)
    c. The users are creating overlapping time pairs (how could a child be in two places at the same time)

5. Validate process end-to-end in UAT:

Once the transmission of attendance into UAT has been verified, the CCMS needs to submit the attendance to DES from KinderSystems. KinderSystems will train the CCMS on how to execute this process. The goal is to compare the payments made in the past against the payment process on the UAT testing.

DES expects to achieve 90% accuracy in order to pass the test.

  1. Going live:

Once the CCMS is approved and meets all requirements, the selected providers will need to assist with training and onboarding sessions with KinderSystems. After the training is finished, providers will be able to start submitting subsidy attendance through KinderSystems in the next available month.

CCMS must provide a support contact for future troubleshooting. Also, it is suggested that user-friendly documentation/videos be created to explain KinderConnect integration.

If you have any questions or doubts about this process, please do not hesitate to contact us at partners@controltec.com.

Best regards,
KinderSystem Team
